Items that can be done by the owner before AES arrives
AES Procedures
- AES Mobilizing / Containment Setup:
- Upon arrival, AES will setup air scrubbers to clean and filter
the air within the building.
- All carpet will be removed in affected areas and in most cases
removed throughout the building if noted on protocol.
- All tack strips will be inspected and if necessary removed.
- All contents within the affected areas will be cleaned and boxed.
along with the furnishings will be moved to other areas of the
building.
It may be necessary to move some or all items to a storage facility
because of limited space available.
-

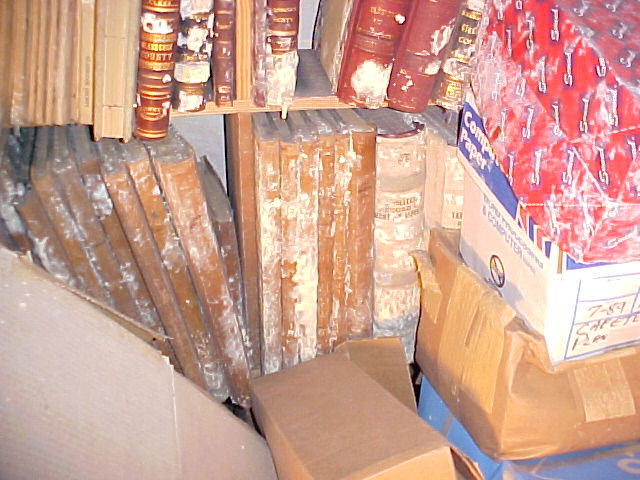

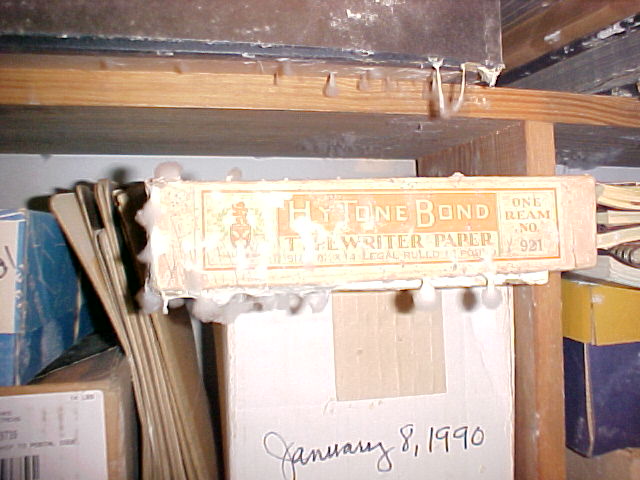

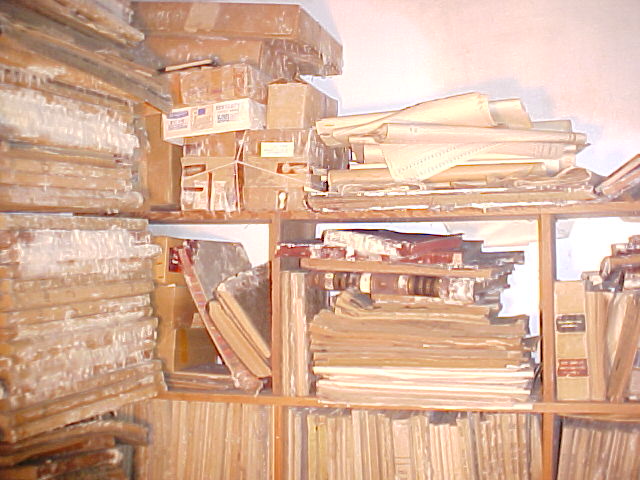

- All affected furnishing and contents with visible molds will be
disposed of.
- In some cases, all contents will be packed out, moved to other
facility, cleaned and stored.

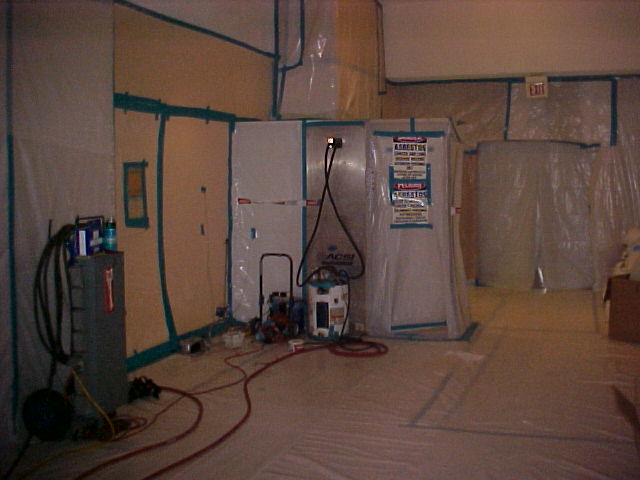

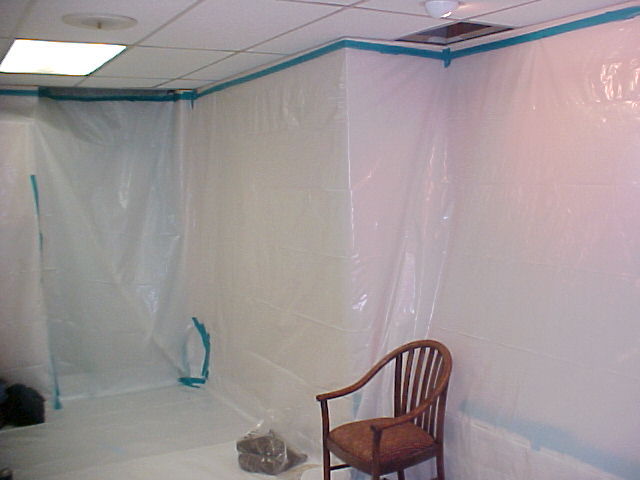

- A plastic containment will be setup to isolate the work areas
from the remaining areas, to keep the rest of building from contamination.

- Air scrubbers will be setup inside containment to clean and filter
air while working.
- A decontamination unit will be setup to the containment for workers
to decontaminate themselves before exiting.

- Remediation:
- All affected cabinets will be removed and inspected for contamination.
If possible, we can cut away the base and the back panel, and the
rest can be salvaged, wrapped in poly and stored on site. If not
they will be disposed of.
- All affected materials will be removed, bagged and disposed of.
Remaining affected stationary or structure materials will be sanded,
biocide, hepa vacuumed and encapsulated. All other non-affected
surfaces to be cleaned and vacuumed.

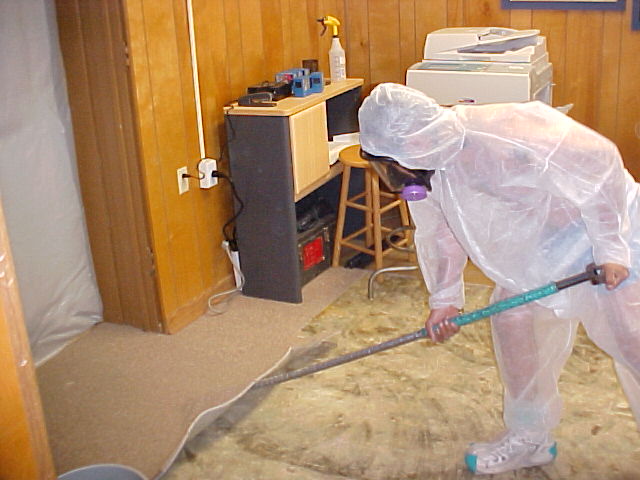

- Most floor coverings within containment will have to be removed.

- Once we start the removal process. a lot of times additional affected
materials are exposed and will have to be removed at least two feet
beyond the contaminated area.
- The containment and air machines are to remain on site until inspection
and final air clearance testing have been achieved.
- For your safety, please do not enter or cut into the containment
after remediation has started. The contamination counts are a lot
greater due to the removal process.
- Furnishings / Misc. Contents / Surfaces - Final Cleaning:
- All closed up items such as china and other small item in cabinets
that have been closed up and hardly ever opened do not need to be
cleaned unless noted on protocol. These items have been sealed and
are airtight.
- If instructed by protocol, all furnishings and contents outside
containment will also be biocide and hepa vacuumed.
- All remaining surfaces will be cleaned and vacuum.
- Clearance Testing: Final air testing and inspection
by the environmental consultant will be completed after completion of
remediation and air scrubbers have been running for 24 - 36 hours.
- Teardown / Demobilizing: All containments and equipment
will be removed upon notice of clearance of clean air.
- Returning of Furnishing / Contents: All contents
will be returned to site if stored in a storage facility after re-construction
is completed. Please give at least 1 - 2 weeks notice if possible.
- Project Duration: On an average building, the estimated
time to complete a project is 1 - 2 weeks depending on the size. The clearance
testing is 5 - 7 days and to demobilize is 1 - 2 days after notice.
- Parking: AES will need to have parking spaces available
for a crew truck, material / equipment trailer and a waste disposal
trailer.
- Its very important to keep in mind that when reconstruction
starts, please inform the contractor to install a plastic critical or
sheeting on the entry to the areas they are working. This will keep
from getting dust throughout the rest of the home. Remember, you have
a very clean house now.
Thank you. |
